Most UK mid-market firms don't start an ERP project because they fancy a new system. They start because the current setup is becoming expensive to live with. HR records sit in one application, payroll files move by spreadsheet, finance approvals happen by email, and managers still chase information across Teams chats, shared drives, and inboxes.
That patchwork creates friction, but it also creates risk. When employee data is duplicated across systems, GDPR controls become harder to enforce. When onboarding relies on manual handoffs, Right to Work checks can be delayed or handled inconsistently. When finance and operations report from different datasets, leadership spends more time debating the numbers than acting on them.
The implementation of ERP works best when it's treated as a business redesign inside a platform your people already use. For many Microsoft 365 organisations, that means Dynamics 365, Dataverse, Power Platform, Teams, Outlook, SharePoint, and Power BI working as one operating layer rather than a set of disconnected tools.
The Strategic Case for a Modern ERP Implementation
A familiar pattern appears in growing organisations. The business adds systems one department at a time. HR buys a specialist tool. Finance keeps the accounting platform. Sales runs CRM separately. Operations build workarounds in spreadsheets because the core systems don't speak to each other properly.
That arrangement can survive for a while. Then growth exposes the weakness. A new starter joins, HR enters the record, IT creates accounts manually, payroll waits for confirmation, line managers don't know whether mandatory documents are complete, and no one has a single version of the truth.
Why the status quo becomes a management problem
The issue isn't only efficiency. It's control.
A modern ERP implementation gives leadership one place to manage processes, data, permissions, reporting, and auditability. In the Microsoft ecosystem, that matters because the platform can connect operational data with the tools staff already use every day. Instead of emailing spreadsheets around for approval, teams can work through structured workflows tied to real records in Dataverse and surfaced in Teams, Outlook, and Power BI.
That shift also aligns with broader market behaviour. A widely cited ERP trend reported that 53% of UK CIOs were looking for more intelligent ERP systems with machine learning, AI, and automation, while 95% of businesses saw business process improvement after ERP implementation and 82% of organisations that planned an ROI timeline achieved ROI in that expected time, according to this ERP trends summary.
For firms still deciding whether to modernise infrastructure first or redesign processes first, this practical piece on transforming your business with cloud is useful because it reflects the same reality we see in ERP projects. Cloud adoption on its own doesn't fix fragmented operating models, but it does make a unified one possible.
The strongest ERP programmes don't begin with software selection. They begin when leadership decides that duplicated data, informal approvals, and manual compliance checks are no longer acceptable.
What a unified Microsoft platform changes
In practical terms, a Microsoft-native ERP estate gives you:
- Shared data across functions so HR, finance, operations, and service teams stop maintaining conflicting records.
- Process consistency through Power Automate, role-based approvals, and standard business rules.
- Built-in reporting context with Power BI pulling from governed operational data rather than disconnected exports.
- A scalable base for change so new workflows can be added without creating another silo.
That's why the implementation of ERP should be judged less by whether the system went live on a date and more by whether the business left behind the habits that made change necessary in the first place.

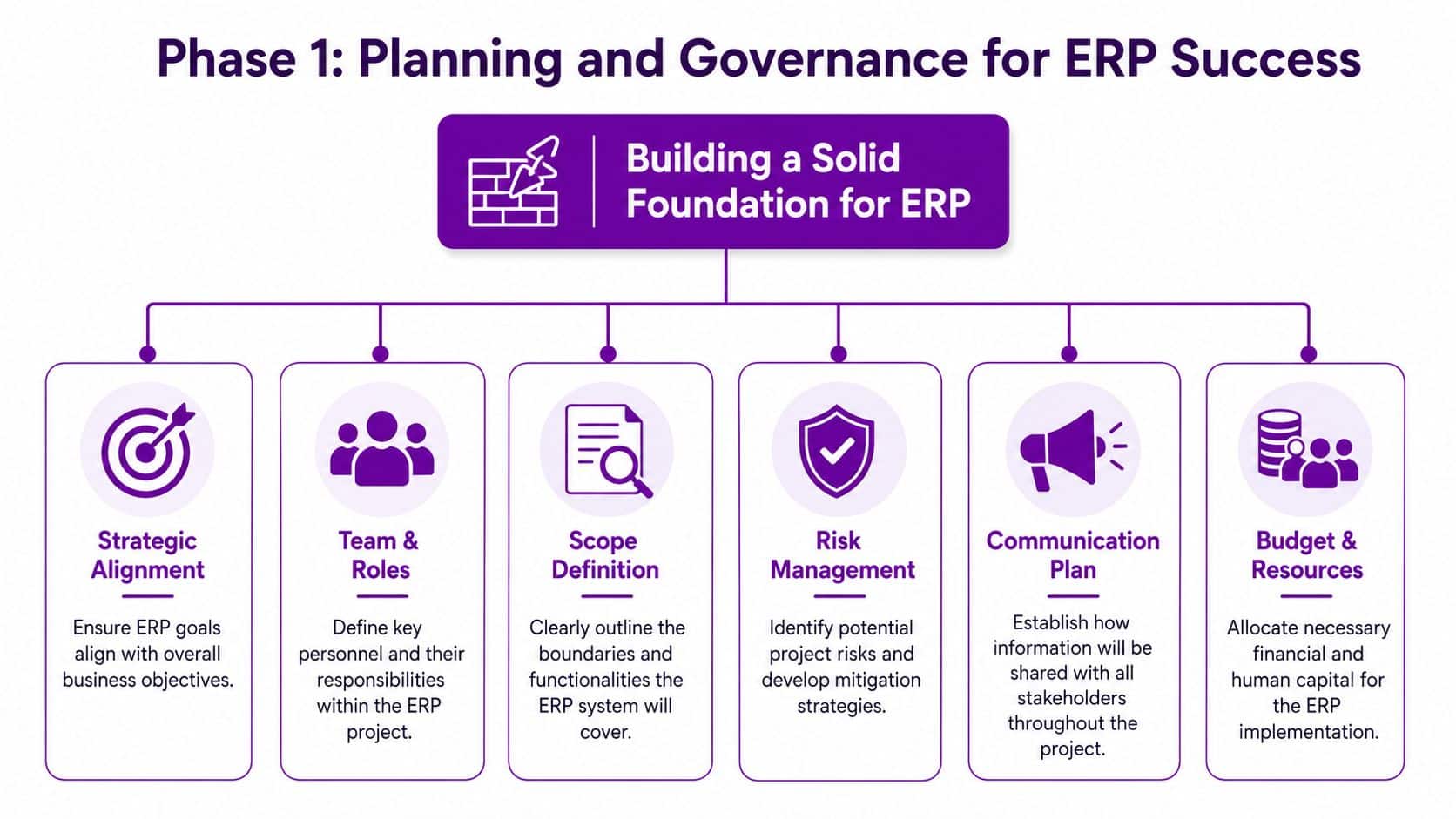

Phase 1 Planning and Governance for Success
Projects usually fail before configuration starts. They fail when the scope is vague, when no one owns decisions, when every department wants an exception, and when the partner is chosen on licence familiarity rather than delivery discipline.

Independent ERP research highlights the scale of that risk. 23% of implementations exceed budget and 50% of ERP projects fail the first time around, with governance named as the primary mitigation in this implementation guidance from ECI Solutions.
Governance first, software second
A working governance model is usually straightforward. It just needs to be real.
| Governance layer | What it should do |
|---|---|
| Executive steering committee | Make scope, budget, risk, and priority decisions quickly |
| Project board | Review progress, dependencies, and issue resolution |
| Workstream leads | Own process design for HR, finance, operations, and data |
| Project champions | Represent users, surface concerns, and support adoption |
If those groups exist only on the project chart and not in the calendar, the programme drifts. Decisions get delayed, customisations pile up, and testing starts before anyone has agreed what “good” looks like.
Scope discipline is where value is protected
A sensible scope defines what the first release must solve and what can wait. That sounds obvious, but many ERP programmes get pulled off course by “small” requests that introduce new data fields, extra approval layers, bespoke reports, or unusual security rules.
Use a change process that asks three things every time:
- Does this support the original business case
- Can the standard platform handle it without heavy customisation
- What is the impact on testing, training, and support
Practical rule: If a requested change adds complexity for many users to satisfy a preference for a few, it usually belongs in a later phase.
A good implementation partner should help you say no when no is the right answer. If you're weighing options, this guide to choosing Microsoft Dynamics partners in the UK is a sensible starting point because the delivery model matters as much as product knowledge.
What to look for in a delivery partner
The partner should understand more than module configuration. In a UK mid-market environment, they need to grasp practical constraints around payroll interfaces, HR record handling, approvals, access controls, audit trails, and user adoption in lean internal teams.
Look for evidence of:
- Microsoft platform depth across Dynamics 365, Dataverse, Power Platform, Teams, SharePoint, and security.
- Process-led design rather than “tell us your fields and we'll build them”.
- Testing discipline with production-like environments and regular demonstrations.
- Regulatory awareness around UK employment and data handling obligations.
The same mindset appears in other change-heavy programmes. Even a project like office relocation IT planning succeeds or fails on sequencing, dependencies, and ownership rather than on hardware alone.
This short video gives a useful overview of planning principles before delivery starts.
Phase 2 Designing Your Microsoft-Centric Solution
A typical mid-market project reaches this phase with a clear risk. The team starts by recreating old forms, old approvals, and old exceptions inside new software. That approach usually produces a system that looks modern but still depends on manual fixes, email chasing, and inconsistent controls.
Design should start with the operating model you want to run in two years, not the workarounds people use today. In a Microsoft-native implementation, that means shaping processes around Dynamics 365, Dataverse, Power Platform, Teams, SharePoint, and Entra ID as one environment, with compliance built in from the start.
A Microsoft-centric design uses Dataverse as the governed data layer. It gives the business a shared structure for records, relationships, role-based security, validation rules, workflow triggers, and reporting across finance, operations, and HR.

Design the process, not just the screens
Strong design workshops go beyond field lists. They define how work moves, who owns each step, what evidence must be retained, and where controls need to sit.
Useful design questions include:
- Where does the process begin
- Who owns each handoff
- Which approvals are required
- What documents must be stored and for how long
- What should trigger a task, alert, or escalation
- Which data points need to feed reporting, payroll, or compliance checks later
Onboarding is a good test case. In a well-designed Microsoft setup, a new starter record can trigger manager tasks, IT provisioning requests, document collection, probation reminders, and policy acknowledgements. Communications can run through Outlook, activity can surface in Teams, and signed documents can be stored in SharePoint against the employee record. That reduces handoffs and gives HR, line managers, and operations a single view of progress.
The same principle applies to finance and payroll touchpoints. If your design does not clearly define how approved HR changes feed downstream processing, errors show up quickly in pay runs and reporting. We usually address that dependency early with a mapped payroll and accounting integration design for Dynamics 365 rather than leaving it for late-stage rework.
Build HR into the core design
HR should not sit on the edge of the ERP programme. In UK firms, HR workflows carry some of the highest operational and regulatory exposure. Right-to-Work checks, GDPR controls, contract records, absence management, occupational documents, and manager approvals all need clear ownership and auditability.
That is why many Microsoft implementations use Hubdrive HR Management inside Dynamics 365 and Dataverse. It supports recruiting, onboarding, employee administration, performance activity, time and attendance, document handling, and compliance-led workflows in the same platform as the wider ERP solution. The practical benefit is simple. HR data and HR actions stay inside the governed Microsoft environment instead of being split across disconnected tools.
For UK mid-market organisations, this matters most in areas that are often left too late:
| Capability | Microsoft-centric approach |
|---|---|
| Employee master data | Dataverse as the controlled core record |
| Collaboration | Teams for manager actions, notifications, and approvals |
| Communication | Outlook emails triggered from workflow events |
| Documents | SharePoint with controlled storage, access, and retention |
| Reporting | Power BI across HR, finance, and operational data |
| Automation | Power Automate for reminders, approvals, and escalations |
A good design also accounts for exceptions. Contractors need different document checks from permanent staff. A warehouse supervisor needs different access from a finance manager. An employee transfer should update reporting lines, equipment ownership, and payroll inputs without relying on someone to remember three separate emails.
Design security and compliance early
Security design belongs in the first workshops because it shapes process design, user experience, and auditability. With Microsoft Entra ID, access can be aligned to real responsibilities across HR, finance, operations, payroll, and management.
That matters in every ERP programme, but especially in people processes. Recruiters, HR advisers, line managers, payroll staff, and directors should not see the same data or perform the same actions. If permissions are too broad, you create GDPR risk. If they are too restrictive, the business falls back to spreadsheets and side conversations.
The same applies to compliance logic. Right-to-Work evidence, document retention periods, consent handling, probation checkpoints, and access to sensitive records should be designed into the workflows and data model at this stage. Retrofitting those controls after configuration is slower, more expensive, and usually less reliable.
A mature design handles standard work cleanly and exceptions safely.
The implementation of ERP in a Microsoft environment should leave the business with a coherent operating platform where process, security, reporting, and compliance reinforce each other across Dynamics 365 and Power Platform. For UK mid-market firms, that is where value starts to become visible.
Phase 3 Data Migration and Integration Strategy
Data migration gets underestimated because it sounds administrative. It isn't. It's one of the clearest tests of whether the organisation understands its own operations.
Most firms discover the same problems once migration work begins. Duplicate employee records. Inconsistent department names. Historic documents with no retention logic. Missing contract dates. Supplier records that no one owns. If those issues are pushed into the new platform, the ERP becomes more visible than before but not more reliable.
Treat migration as a business workstream
A workable migration sequence is simple, but it needs discipline.
-
Audit the source data
Identify what exists, where it lives, who owns it, and whether it's still needed. -
Clean the data
Remove duplicates, close obsolete records, standardise values, and fix obvious errors before mapping begins. -
Map to the new model
Decide where each record belongs in Dynamics 365 and Dataverse, and what no longer deserves a place. -
Validate with users
Business owners must check whether the migrated data makes operational sense, not just whether files loaded successfully. -
Rehearse the migration
Run a full practice migration into a non-production environment and review defects before final cutover.
If a team says, “We'll clean it after go-live”, they usually mean the business will carry poor data into production and pay for it in support effort.
Integration should be selective and deliberate
Not every system should disappear in phase one. A lot of UK mid-market organisations retain specialist tools for payroll, sector-specific operations, or reporting. That's fine, provided the integration model is explicit.
You need to decide:
- Which system is the master for each data domain
- How often data should move
- What should be automated and what should stay controlled
- How failures will be monitored and corrected
For HR and finance in particular, payroll integration needs careful ownership. The handoff points between employee changes, pay-impacting events, approvals, and accounting outputs should be defined before build starts. This article on payroll and accounting integration in Microsoft environments is a useful reference if you're planning around those dependencies.
What works better than blanket integration
A selective pattern usually works best:
- Core records in Dataverse for staff, roles, organisational structure, and controlled process data.
- Document storage in SharePoint where retention and access can be managed more cleanly.
- Workflow orchestration in Power Automate for approvals and notifications.
- Reporting through Power BI rather than maintaining separate reporting datasets across departments.
The aim isn't to integrate everything because you can. It's to connect the systems that need dependable operational exchange and retire the interfaces that only preserve old habits.
Phase 4 Compliance Testing and Change Management
This is the phase where projects become real for users. Configuration may look correct in workshops, but that tells you very little about whether the business can operate safely, compliantly, and confidently on day one.

Independent implementation guidance frequently places ERP failure rates between 55% and 75%, with staged rollout and rigorous testing recommended as the corrective approach in this analysis of ERP implementation failure.
Compliance belongs inside the workflow
For UK organisations, compliance can't sit in a policy folder while operations happen elsewhere. It has to be reflected in how the system behaves.
In HR-led implementations, that usually means embedding controls such as:
- GDPR-aware retention handling for employee and candidate records
- Right to Work process steps within recruitment and onboarding
- Role-based access restrictions for sensitive personal data
- Traceable approval paths for contractual and people-related changes
If the system allows users to bypass those controls in routine work, the compliance design isn't finished. A strong principle is to make the compliant route the easiest route.
For teams reviewing Microsoft-centric controls in this area, data protection by design in Dynamics 365 is a useful model for how governance and usability should sit together.
Testing needs real scenarios, not isolated clicks
A lot of weak testing happens because scripts are written around fields and buttons rather than outcomes. Users confirm that a form saves, an approval sends, and a report opens. Then go-live arrives and a full process fails because one handoff was never tested under realistic conditions.
The staged sequence that works is:
| Testing layer | What it should prove |
|---|---|
| Conference room pilot | Common, high-volume scenarios work end to end |
| Departmental pilot | Edge cases and lower-frequency scenarios are covered |
| Integrated UAT | Cross-functional transactions complete without manual rescue |
| Performance and security testing | The platform holds up under realistic usage and access rules |
That matters especially in hire-to-retire flows. A candidate might be approved correctly, but if document capture, manager notifications, account provisioning triggers, or payroll-relevant fields aren’t tested together, the process still breaks.
Test the handoffs. Most ERP failures happen between teams, not inside one screen.
Change management is operational, not cosmetic
Training alone won’t carry adoption. Users need context, confidence, and proof that the new process is better than the old workaround.
What usually works:
- Named champions in each function who can explain changes in local, practical terms
- Role-based training built around daily tasks, not generic feature tours
- Frequent demonstrations of working software so users aren’t surprised late in the project
- Visible escalation routes after go-live so staff know where to raise issues
What doesn’t work is a late blast of training materials with no ownership from line managers. People adopt new systems when they can see how the work will flow on Monday morning, who approves what, where documents go, and what happens if something fails.
Compliance, testing, and change management depend on each other. Weak testing undermines compliance. Poor change management leads users around the controls. Weak compliance design creates manual workarounds. Treat them as one delivery thread.
Phase 5 Go-Live Stabilisation and Measurement
Go-live is a milestone. It isn’t proof of success.
The practical mistake many firms make is to treat launch day as the end of the implementation of ERP. In reality, the period immediately after cutover tells you whether the design, data, training, and governance were good enough for live operations.
Independent ERP commentary notes that a 3–6 month stabilisation period is commonly needed after go-live, and that 95% of businesses ultimately saw business process improvements after ERP implementation, according to this post-go-live ERP analysis.
The first weeks need controlled support
A sensible cutover plan should already define:
- Who approves the final production move
- Which transactions are paused or monitored closely
- How incidents are logged and prioritised
- Who can make urgent fixes
- What communication users receive each day
Most organisations benefit from a hypercare model during the early period. That means functional leads, technical support, and decision-makers remain closely available while users settle into the new process. The point isn’t to continue building. It’s to protect operational continuity while real-life issues surface.
Stabilisation is where adoption becomes visible
The next months are about pattern recognition. Which teams are still using workarounds. Which approvals stall. Which reports leaders trust. Which automations are saving effort and which ones need refinement.
A practical stabilisation review usually looks at four things:
| Review area | Questions to ask |
|---|---|
| Process adherence | Are users following the intended workflow |
| Data quality | Are records being completed accurately and consistently |
| Support trends | Which issues repeat and what do they reveal |
| Business outcomes | Are original pain points actually reducing |
Go-live proves the platform can run. Stabilisation proves the organisation can use it well.
Measure against the business case
Power BI becomes useful. Not because every project needs a dashboard collection on day one, but because leaders need visible evidence that the new operating model is improving control and throughput.
Measure what mattered in the original case for change. That may include onboarding cycle visibility, approval delays, document completion, reporting timeliness, or exception volume. Keep the measures close to operational reality. If the metric can't influence a management decision, it probably doesn't belong in the first wave of reporting.
The long-term value of ERP comes from process reliability plus visibility. One without the other leaves the business either blind or overloaded.
Conclusion Continuous Optimisation and Future-Proofing
Six months after go-live, the better question is no longer whether the system works. It is whether the platform is helping the business adapt without creating new risk.
That is the fundamental long-term case for a Microsoft-native ERP environment. Dynamics 365 gives the business a core operating platform, and Power Platform extends it in controlled, targeted releases. For UK mid-market firms, that matters because change rarely comes from one source. It comes from new reporting needs, revised approval paths, GDPR controls, Right-to-Work processes, and higher expectations from managers and employees who want simpler digital experiences.
Future-proofing comes from controlled evolution
The strongest post-go-live programmes run on a release cadence, not on one-off requests. A recurring issue is identified, the business case is checked, the change is designed, tested, documented, and then deployed with clear ownership. That approach protects process integrity and stops local workarounds from creeping back in.
In practice, the next wave of improvements often includes:
- Manager self-service updates for approvals, employee changes, and document visibility
- Power Apps for specific operational gaps in field teams, shared services, or departmental workflows
- Better reporting packs for finance, HR, and operational leadership
- Power Automate refinements that reduce repetitive admin while preserving auditability
- Compliance-by-design improvements for GDPR retention, Right-to-Work tracking, and document handling
For businesses with a growing people function, HR is usually where future-proofing either holds together or starts to fragment. If employee data, documents, approvals, and compliance tasks sit outside the Microsoft stack, reporting gets weaker and control gets harder. If those processes are built into the wider Dynamics 365 model from the start, the business gets a more consistent hire-to-retire foundation.
The right mindset after launch
Post-go-live governance should stay practical. Ask which manual tasks still consume time, where handoffs still fail, which controls are too dependent on individual knowledge, and what new requirements are coming from the business or from regulation.
That is especially important for UK firms balancing growth with compliance.
Hubdrive fits well here because it extends Dynamics 365 for HR in a way that aligns with the broader Microsoft platform, rather than creating another disconnected toolset. For organisations that need modern HR capability alongside ERP, including onboarding, employee administration, document processes, and compliance support, it gives a clearer route to scale inside the same ecosystem.
As Hubdrive's accredited UK partner, DynamicsHub can help you build that future-ready platform with compliance and adoption designed in from the start. For a personalised discussion about your ERP journey, speak with DynamicsHub. Phone 01522 508096 today, or send us a message.
